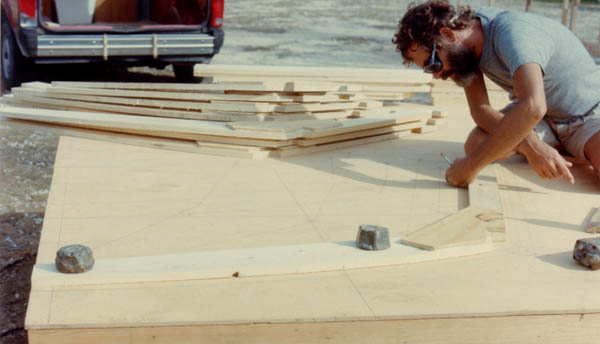

Doug Gill lofting the design mold frame stations for the T-34 |

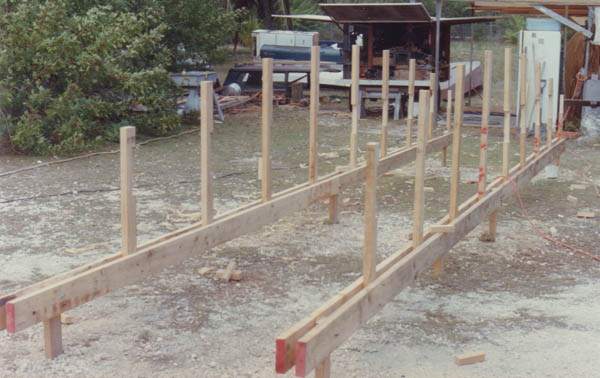

The strongback with stanchions for the mold frames; "Taco Stand" in the rear |

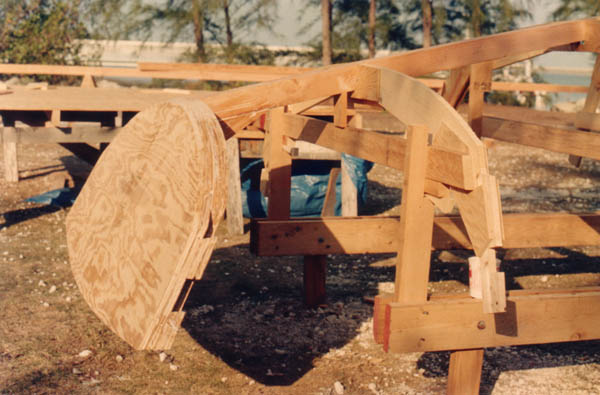

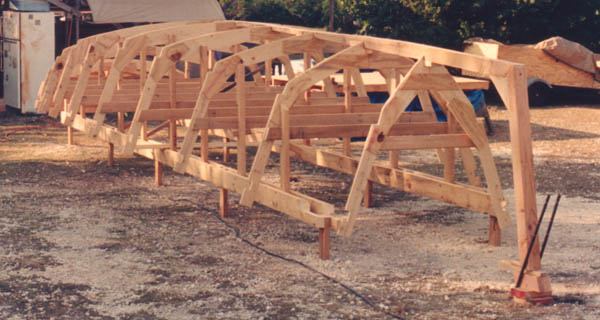

Mold frames mounted on the strongback; plank keel, forefoot log & apron in place |
The laminated plywood transom with perimeter cleats, knee & horn timber in place |

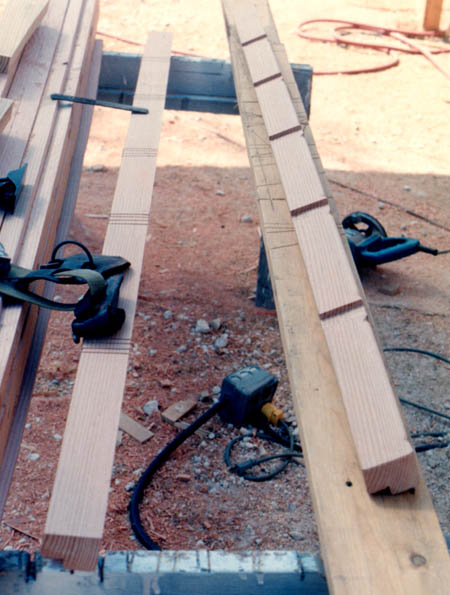

Longitudinals (sheer clamps, chine logs & bilge stringers) in place; note rabbeted chine logs |
The first (of two) diagonal layer of 5/8" plywood planking started; note allignment blocks |
Keel first layer being laid; centerboard slot has been drop-cut |

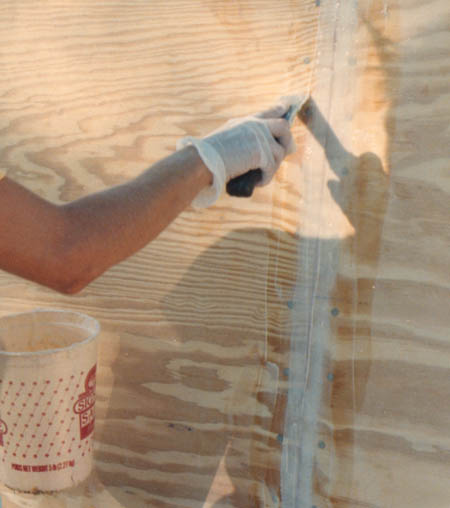

Topsides planking butts are ground hollow & taped with 2" glass & thickened epoxy |

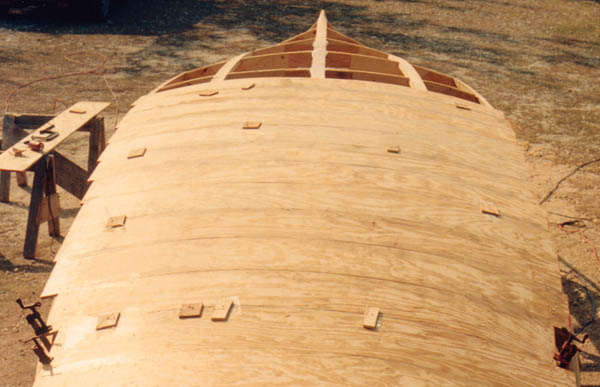

Hull planking complete; keel finished; ready for Xynole-polyester cloth & epoxy |
The fabric-covered, epoxy-primed hull being turned using "square wheels", wood A-frame, and the winch on the front of my IH Scout |
The righted hull; note buttblocks for topsides planking and spacers used to hold hull shape |

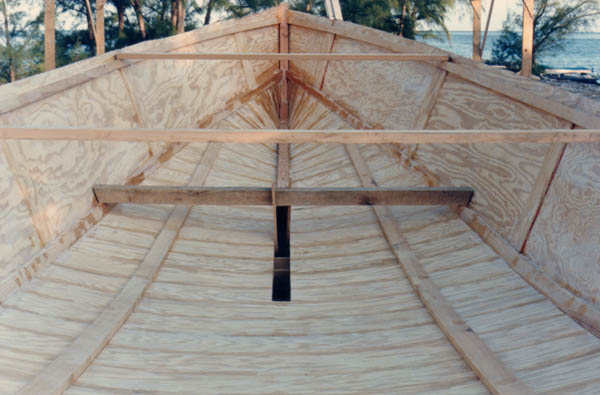

The hull interior sanded and saturated to rejection with thin penetrating epoxy |

Bulkheads being installed |

The offset outboard well |

The galley being framed; apperture for the gimbaled stove |

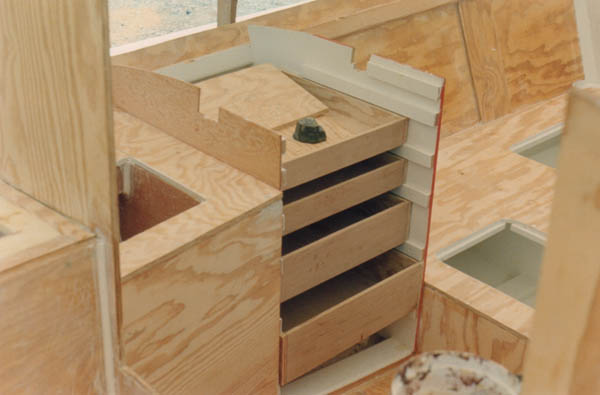

The galley showing drawer banks, icebox (left) & berth/settee (right) |
Cabin trunk carlins being made; notches are for side deck beams, rabbets are for cabin trunks |

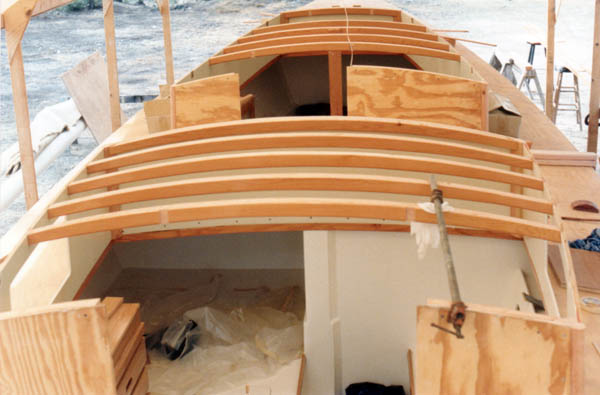

Deck beams and trunk carlins being installed; note blocks fit between beams above sheer clamps |

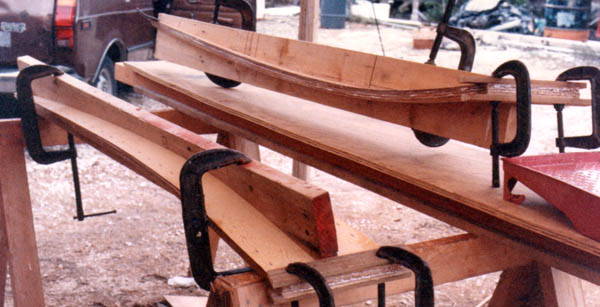

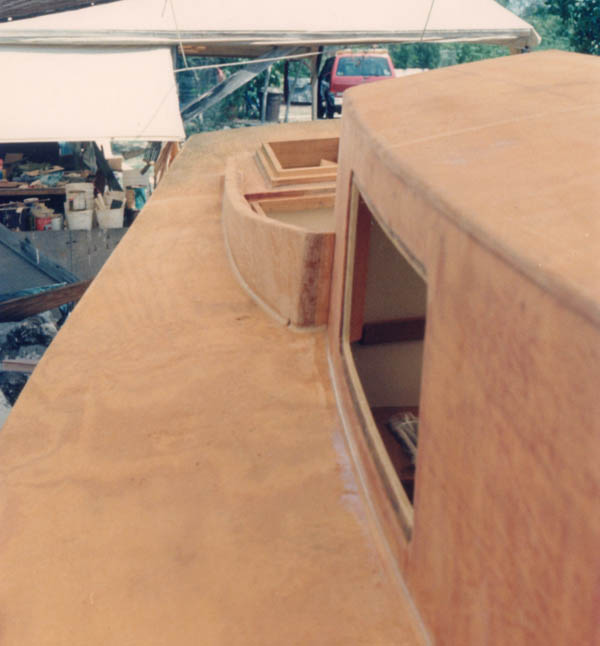

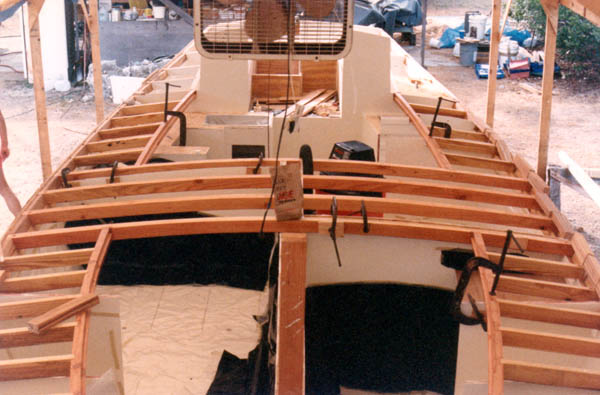

Cabin trunk sides & ends are in place and coachroof beams are being installed |
Cockpit coamings are laminated using plywood |

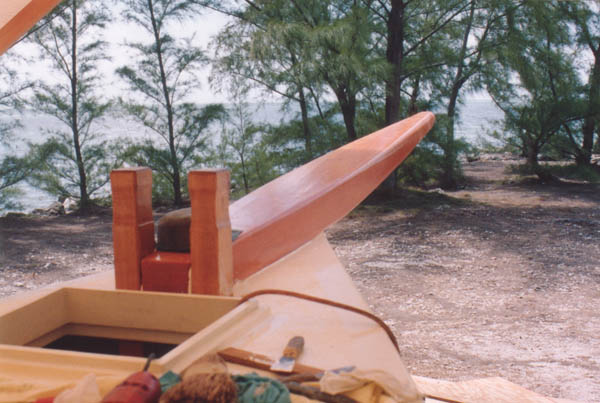

The coachroof laid, cockpit finished, Xynole & epoxy covering all |

Bulwarks from Douglas fir 2x6's ready to be installed |
Interior trim & cabinetry getting started |
Mooring bitts & bowsprit in place |
The centerboard has plywood laminated over a foil-shaped solid stack-laminated core |
The rudder in place; also plywood over a solid shaped core |

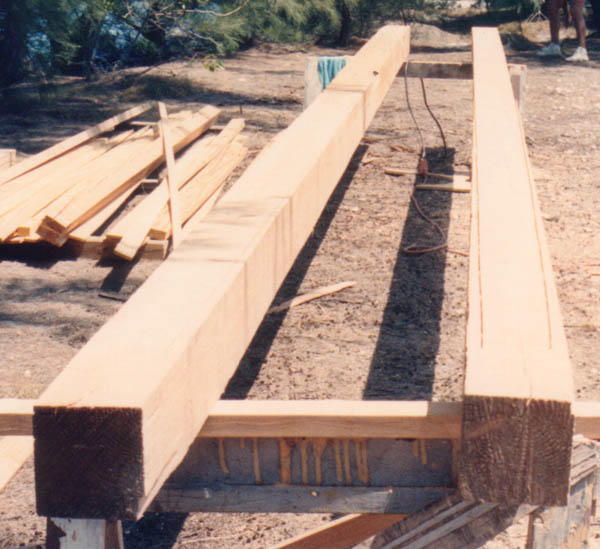

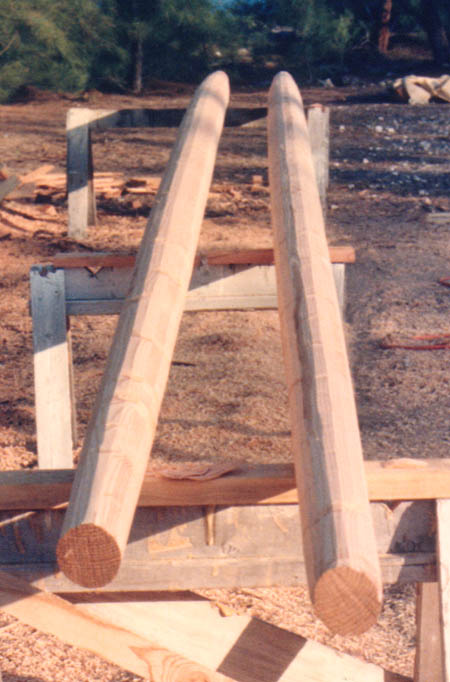

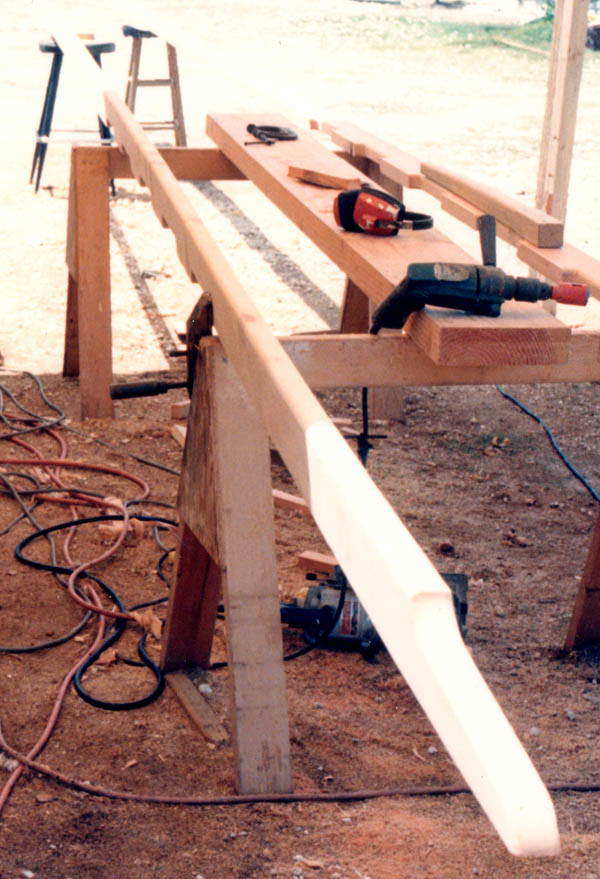

The solid 6x6 full-length Douglas fir masts being laid out for tapering |

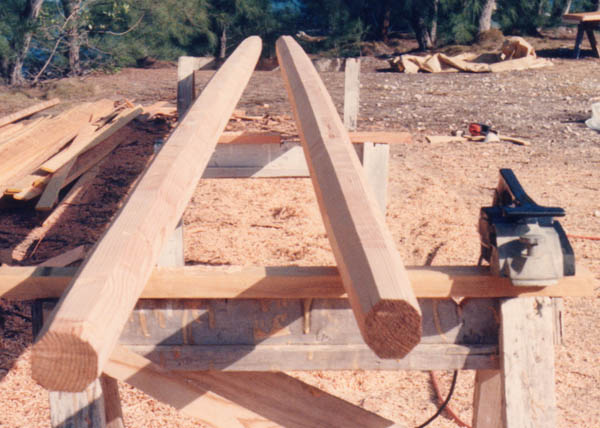

Mast taper has been cut, squared and trimmed octagonal, using a large circular saw |

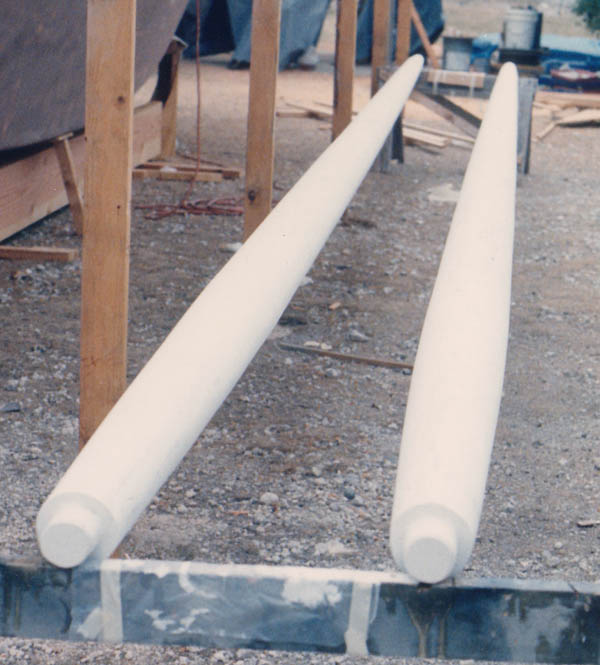

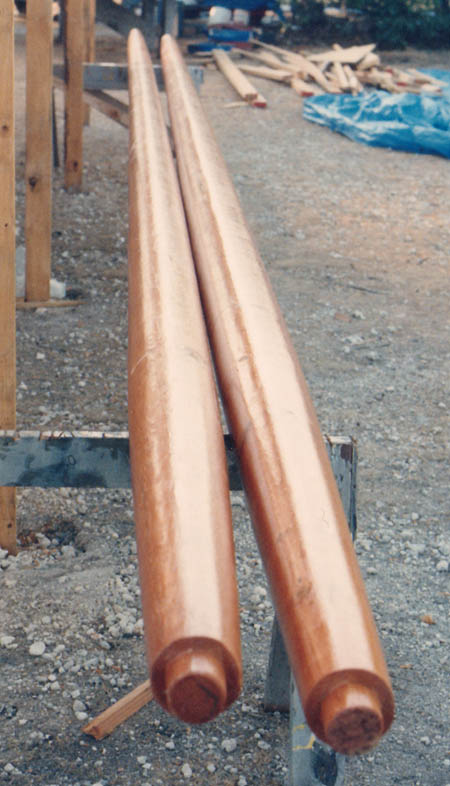

The masts have been power-planed to 16, then 32 sides |

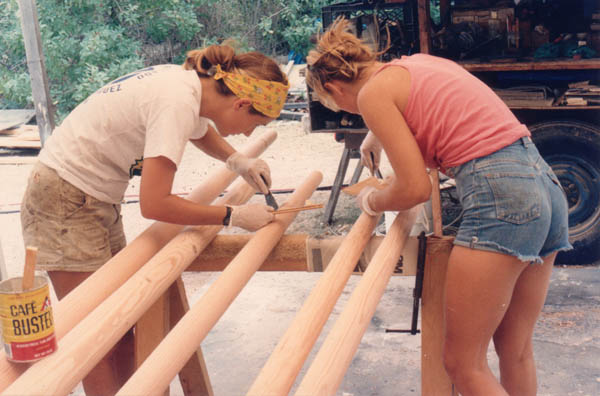

Step tennons are finished; masts sanded and epoxy sealed |
The masts are epoxy primed prior to application of linear polyurethane finish coats |
Booms & gaffs have been shaped & sanded, now receiving epoxy putty prior to primer & paint. My operations are always "asses & elbows"--they should look nice as well as work hard! Note the "Taco Stand" tool trailer in the background and the Cafe Bustelo can ("Cuban Crank") |
|

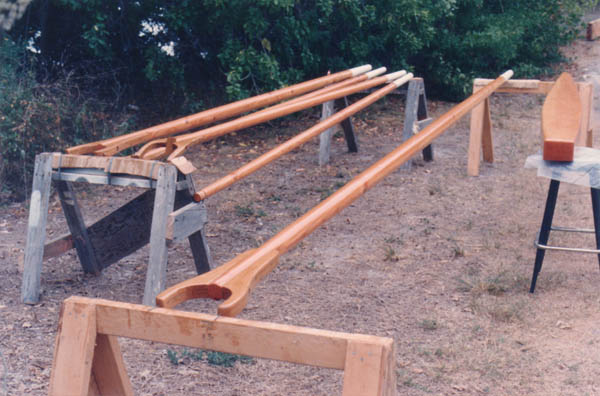

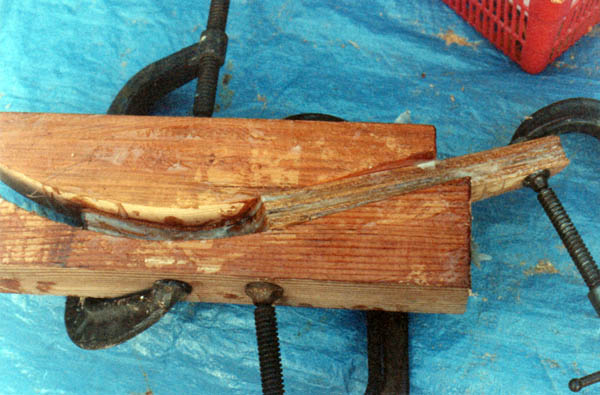

White oak boom & gaff jaws being dry-fitted before thru-bolting with SS allthread; note space between gaff jaws for clappers |
Spars being varnished & painted |
Beth Stevens, my chief helper and girlfriend (near the end) building TOMFOOLERY |
The prototype Terrapin 34 TOMFOOLERY finished prior to stepping the masts. Total construction time from lofting to launching was 16 weeks |
|
TOMFOOLERY in the slings; the whole gang assembled on the dock; Reuel Parker is shirtless, by the centerboard -- Islamorada, Florida Keys, July 14, 1989 |
|
TOMFOOLERY during sail trials in Islamorada |
|
TOMFOOLERY |
